Award-winning execution of complex industrial rigging and duct replacement—recognized by IMPACT as the 2015 Project of the Year for Industrial Rigging & Machinery Moving.

Structural Steel & Equipment Installation

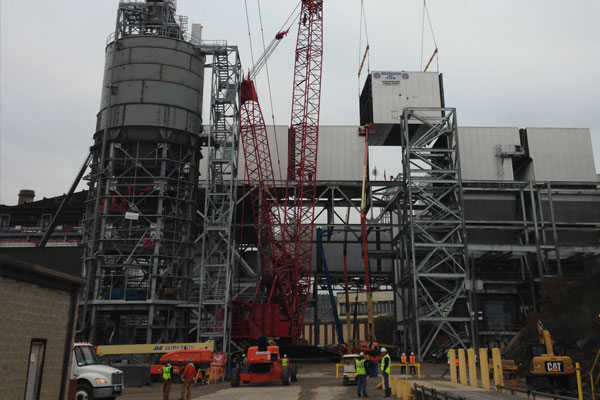

  • Erected 9,356 tons of structural and reinforcing steel supporting large-scale emissions control and baghouse systems
  • Installed baghouse structures, booster fans, dampers, and associated structural support steel using large crawler cranes, many with super-lift configurations

Heavy Rigging & Machinery Moving

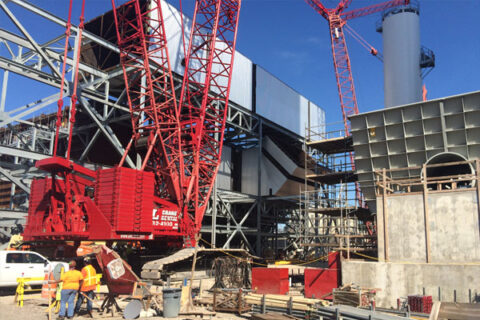

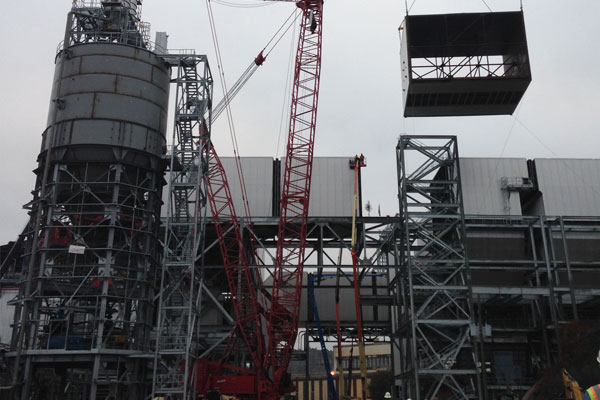

  • Executed complex industrial rigging involving dual and multi-hook critical lifts
  • Performed high-risk rigging operations within confined and active plant areas
  • Coordinated crane movements through a precisely sequenced critical-path lift plan

Ductwork Replacement & Outage Execution

  • Performed major duct replacement and tie-ins during a scheduled outage, requiring tight sequencing and coordination
  • Achieved gas-tight duct completion 2½ shifts ahead of the outage schedule, enabling early return to service

Schedule Performance & Project Phasing

  • Executed work over a two-year project duration, consisting of two primary phases
  • Completed both phases ahead of schedule, including outage work
  • Managed removal and installation activities on an hour-by-hour basis during critical outage windows

Safety, Labor & Collaboration

  • Executed approximately 300,000 total man-hours with a peak manpower of 156 craft professionals
  • Delivered the project under NSC’s zero-incident safety culture, earning owner recognition for safety, planning, and execution excellence
